05/02/2025 - Articles
Risk management in projects: fundamentals, methods, and practical knowledge
Every project involves risks—the question is how we deal with them. Whether hidden obstacles or obvious dangers, identifying and managing risks early on ensures the long-term success of your project. In this comprehensive guide, you will learn how professional risk management works, which methods really help, and why it is no longer just about avoiding problems. A must-read for anyone who wants to bring projects to a successful conclusion!
Contents:
- Why is risk management important in project management?
- Basics of risk management
- Risk management process: From plan to practice
- Types of risks and classifications
- Tools for risk identification: 5 methods
- Techniques for risk analysis and assessment
- Risk management: Seize opportunities, control threats
- Risk management without chaos: Clear communication and documentation
- Create a risk management plan
- Specific methods in risk management
- Roles, responsibilities, and cooperation in risk management
- Typical mistakes in risk management
- Risk management in agile projects
- Software for efficient risk management
- The added value of systematic risk management
Safety first: Why is risk management so important in project management?
Risk management is one of the key factors for success in any project – and for good reason. You know that in a world full of uncertainties, you can't afford to be unprepared. Sudden budget cuts, technical difficulties, or unexpected staff shortages can throw even the best-laid plans off course. This is exactly where risk management comes into play.
But why is risk management so important? It's simple: if you know the risks, you can control them. Companies that identify risks early on, assess them, and take targeted countermeasures not only protect themselves against surprises, but also significantly increase their chances of success.
Many companies view risk management as purely damage control. But it's much more than that! A well-designed risk management system helps to:
Keep projects stable: Risks that are identified early on can be mitigated in a targeted manner.
Avoid costly mistakes: Preventing mistakes saves time, money, and stress.
Secure competitive advantages: Those who actively manage risks can respond more quickly and flexibly to changes.
Create planning security: You create a stable framework that allows for flexibility and quick reactions.
Convincing stakeholders: Investors and customers trust companies that plan ahead.
Seizing opportunities: In addition to dangers, a systematic approach also reveals hidden potential.
Risk management is therefore not an end in itself, but an investment in the long-term success of your project.

Definition: What is risk management?
The ISO 31000 standard defines risk management as the “systematic approach to identifying, analyzing, evaluating, controlling, and monitoring risks” – a process that helps organizations turn uncertainties into measurable quantities.
Fundamentals of risk management: Understanding risks and exploiting opportunities
A solid understanding of the fundamentals is the foundation for effective risk management. In projects, you encounter risks in many different forms – and this is precisely where the key lies: risks offer not only potential dangers but also attractive opportunities if you interpret and manage them correctly.
What are risks in a project context?
In project management, risks are understood as possible events that can influence the course of a project – either through negative effects or unexpected opportunities. ISO 31000 officially defines risks as “effects of uncertainty on objectives” (source: ISO 31000). This definition makes it clear that risks are not only threats, but also opportunities that you can seize.

ISO 21500 – Project management with integrated risk perspective
Projects are inherently risky. ISO 21500, an international standard for project management, emphasizes the importance of well-thought-out risk management. It describes proven methods for identifying risks early on and controlling them through targeted measures.
Opportunities versus risks – a differentiated view
You should always bear in mind that risks have two sides:
Risks: Events that have a negative impact on the course of the project.
Opportunities: Potential that, if correctly identified, can lead to additional success.
To make this duality tangible, it is advisable to draw up a clear comparison:
Risk as a threat | Risk as an opportunity |
---|---|
|
|
Objectives and benefits of systematic risk management
ISO 31000 defines risk management as “the coordinated activity of directing and controlling an organization with respect to risks.” The standard provides a generic framework for all companies, regardless of size or industry. Its goal is for organizations to not only minimize risks, but also to understand them as opportunities and use them strategically.

Risk management definition according to DIN 69901-5: 3.99
Systematic application of management principles, procedures, and practices to determine the context and identify, analyze, evaluate, control/manage, monitor, and communicate risks.
A systematic approach helps you to identify and manage risks holistically. This enables you to achieve the following goals:
Early detection: You identify risks before they become obstacles.
Structured assessment: You can prioritize risks according to their probability of occurrence and impact.
Targeted control: You develop measures that not only avert dangers but also reinforce positive effects.

Practical tip
Create a risk register in which you document all identified risks with a brief description, assessment, and planned measures. This will make it easier for you to continuously monitor and adapt your approach.
Systematic risk management ensures project success and transforms uncertainties into strategic advantages. It lays the foundation for an agile and forward-looking project culture in which you minimize risks and maximize opportunities.
Risk management process: From plan to practice
Effective risk management does not begin when the first problem arises – it is an integral part of a successful project from the very beginning and starts in the project initiation phase. The risk management process helps to identify uncertainties, take targeted measures and thus ensure long-term project success.
The process follows a clear structure: from strategic planning, identification, analysis, and evaluation of risks to planning and implementation of measures and continuous monitoring and adjustment of measures, and finally to documenting lessons learned from risk management in past projects for future projects.
Setting the course early on: integration in initiation and planning
Every company and every project involves individual risks. That is why risk management begins with sound basic planning that answers the following questions:
What are our goals? Without clear project goals, it is difficult to prioritize risks.
What framework conditions do we need to consider? Are there legal requirements, company guidelines, or industry-specific standards?
Who is responsible? Risks do not disappear on their own—they require clear responsibilities.
What methods and tools do we use? Depending on the project, different tools are suitable, ranging from simple checklists to specialized software solutions.
What tolerance limits apply to risks?
Here, it pays to refer to existing standards such as ISO 31000 or the PMBOK Guide to establish a proven structure for risk management. Companies that skip this step risk basing their risk management on gut feeling rather than sound processes.
Risk identification: You can only plan with known risks
The next step is to systematically identify and describe potential risks for the specific project. Various methods are used for this purpose:
Brainstorming and expert discussions: The experience of team members is often the best source of risks.
Checklists and historical data: Similar projects from the past provide valuable information.
SWOT analyses: A structured examination of strengths, weaknesses, opportunities, and threats.
We present further effective methods for risk identification in Chapter 5.
Analysis and evaluation during the planning phase: Transparency is key
In the subsequent planning phase, the identified and described risks are analyzed and evaluated. Proven methods such as Failure Mode and Effects Analysis (FMEA) or Monte Carlo simulation are used here to evaluate risks quantitatively and qualitatively. The aim is not only to identify risks, but also to actively incorporate them into project planning. After all, a good plan is not one that lets everything run smoothly, but one that is also prepared for turbulence.
An assessment is therefore made based on two key questions:
- How likely is it that this risk will occur? (Probability of occurrence)
- What impact will it have on the project? (Damage potential)
These questions help to classify risks into different risk categories or risk classes and to set priorities. Particularly critical risks deserve special attention.

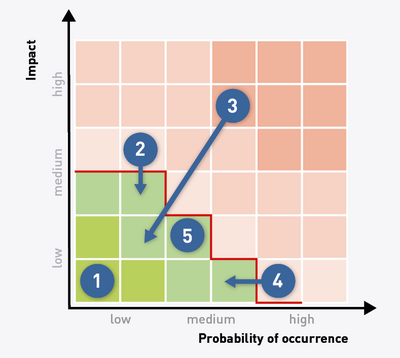

Standardized methods such as risk matrices, which classify risks according to their probability of occurrence and level of damage, are helpful here. An example:
Probability of occurrence | Impact | Risk class |
---|---|---|
High | Low | Medium |
Medium | Medium | Medium |
Low | High | Medium |
High | High | Critical |
Only those who know their risks can manage them – and that is precisely the next step.
Action planning and implementation: From risk to solution
Identified risks are now minimized or even eliminated with targeted measures. There are four basic strategies for dealing with risks or risk treatment:
Avoidance (risk avoidance): If a risk is too dangerous, it may be advisable to redesign the corresponding process or project so that the risk does not arise in the first place. If a risk can be prevented by adjustments to the project, this is the best solution.
Reduce (risk reduction): Technical or organizational measures can minimize the probability of occurrence or the impact of risks (e.g., additional security mechanisms in IT or alternative suppliers for risk diversification).
Transfer (risk transfer): Insurance policies or contracts with external partners shift the risk to other parties, who then assume part of the risk.
Accept (risk assumption): Sometimes a risk is so low that it can be tolerated or consciously accepted.
Once specific measures have been defined to deal with the risks, corresponding key performance indicators must also be defined so that the success of the respective measures can be measured later. The frequency, responsibility, and intensity of the monitoring measures should also be planned as precisely as possible.
Monitoring, managing, and adapting: Risk management during the implementation phase
Good risk management does not end with the implementation of measures—it remains an ongoing process. An assessment of the current risk situation is part of every project status report. Regular reviews and control mechanisms during the course of the project ensure that risks are not overlooked and that measures taken remain effective or need to be adjusted, or even that new risks have arisen – which is why risk management should be continuously evaluated and updated in everyday project work.
This includes
Regular risk reviews: Are the original risks still relevant? Have new ones developed?
Early warning indicators: What signals indicate that a problem is escalating?
Crisis response plans: What should be done if a risk actually occurs?
Successful projects establish dynamic risk strategies – this means not only documenting risks, but also dealing with them proactively. Teams that master this are less likely to encounter surprises and gain room for maneuver.
Once learned, never forgotten: lessons learned and the final phase
Projects do not end with the last task completed, but with the question: What can we learn from this?
At the end of a project, a structured lessons learned analysis is just as much a part of risk management as risk identification at the beginning. After all, today's mistakes are tomorrow's optimization potential and opportunities.
Important questions to ask at the end:
Which risks actually materialized and which did not?
Which measures were successful and which were not?
How effective and efficient were the measures?
How can future projects benefit from these findings?
Clear documentation ensures that future projects do not start from scratch, but build on past experience.
Types of risk and classifications: An organized view of uncertainties
Not all risks are the same. Some affect internal processes, while others arise from external factors. Systematic classification helps to manage risks in a targeted manner and set priorities.
Internal risks (arising from the company or project) | External risks (no direct control, but still manageable) |
---|---|
|
|
While internal risks can often be reduced through organizational measures, external risks require flexible and forward-looking planning.
Operational, strategic, technical, and financial risks: The four major categories
Operational risks | These relate to processes within a project or company. Typical examples include faulty processes, quality problems, or logistical bottlenecks. |
Strategic risks | These result from long-term decisions and market changes. They include disruptive innovations, bad investments, or incorrect product strategies. |
Technical risks | These arise from dependencies on technologies, inadequate IT security, or technical malfunctions. |
Financial risks | These include currency fluctuations, unexpected cost increases, or the insolvency of partner companies. |
A company may have to manage several of these risks at the same time – a good risk management strategy therefore considers all categories together.
Systematic classification: Orientation towards proven standards
International standards such as ISO 31000 or the PMBOK Guide provide structured approaches to risk classification:
ISO 31000 | This international standard provides a general framework for risk management and applies across all industries. It describes principles and processes that help organizations systematically identify, assess, and manage risks. ISO 31000 takes an iterative approach that views risks not as one-time threats, but as a continuous process. Companies benefit from a uniform methodology that makes decisions more transparent and improves risk management in the long term. |
PMBOK Guide (Project Management Body of Knowledge) | PMBOK Guide (Project Management Body of Knowledge) The PMBOK Guide, published by the Project Management Institute (PMI), provides a detailed classification of risks specifically for project management. It describes how risks can arise in the various phases of a project and which methods are suitable for analysis and control. These include qualitative and quantitative risk assessments, risk registers, and risk management strategies. The PMBOK Guide offers a practical basis for implementing effective risk management, especially for companies that work according to PMI standards. |
Compliance with such standards ensures clear and traceable risk assessment. They also enable comparison with other projects and companies.
Risk identification tools: 5 methods for cleverly detecting risks
Risk management without suitable methods is like looking for a needle in a haystack – or worse: you only notice the needle once it has already pricked you. Fortunately, there are proven tools for defining risks that can be used to identify them systematically. Which method is the best? That depends on the situation, the people involved, and the resources available.
No single method is perfect on its own. Successful risk management combines creative, interactive, and analytical approaches to identify risks early and comprehensively.

Risk identification definition according to DIN 69901-5: 3.98
Recording of all risk factors identified as relevant to a project that could have a negative impact on it.
Brainstorming, workshops, and expert interviews: Harnessing collective intelligence
Brainstorming: One of the oldest but most effective methods for identifying risks. Teams gather in an open forum to collect potential risks without evaluating them directly. Creative chaos with a system!
Workshops: Interactive sessions in which stakeholders work together to identify risks. Particularly valuable when different perspectives are needed.
Expert interviews: In-depth discussions with specialists help to avoid blind spots. Experts contribute experience and industry-specific knowledge that is otherwise easily overlooked.
These methods work particularly well in early project phases or in unclear risk scenarios.
The Delphi method: Wisdom of the many
The Delphi method relies on iterative surveys of a group of experts. Here's how it works:
- A moderator asks a group of experts about possible risks.
- The answers are summarized anonymously and presented to the experts again.
- After several rounds, consistent assessments emerge.
The advantage: No loud opinion leaders influence the discussion, and well-founded assessments prevail.
Checklists: Because forgetting is not an option
Standardized checklists are particularly useful for recurring projects or industries with fixed risk patterns. They contain typical risk areas and facilitate systematic review. But be careful: checklists are no substitute for thinking for yourself!
SWOT analysis in risk management
SWOT stands for Strengths, Weaknesses, Opportunities, and Threats. A SWOT analysis helps identify both internal and external factors that can influence a project. It is often used to identify risks and better assess their impact.

Strengths
In a project context, this refers to the internal resources, capabilities, or advantages that the project has. These include experienced team members, strong partnerships, or solid finances.
Example in risk management: Identifying strengths, such as a strong project team or advanced technical knowledge, can help mitigate risks such as inexperienced team members or a lack of expertise.

Weaknesses
These are internal factors that can jeopardize the project. Weaknesses can include a lack of resources, inadequate planning, or a lack of experience.
Example in risk management: A weakness in a project could be a lack of expertise in a particular area, which leads to risks such as delays or errors in implementation.

Opportunities
External factors that could have a positive impact on the project. These opportunities could arise from technological developments, new markets, or partnerships.
Example in risk management: Opportunities could arise if a new technology becomes available that makes the project more efficient or cost-effective. However, the project team must keep an eye on risks such as unforeseen challenges in integrating this technology.

Threats
These external factors can potentially have a negative impact on the project, such as new legal regulations, economic uncertainty, or new competitors.
Example in risk management: Threats could include legal changes that cause additional costs or jeopardize the planned deadlines.
How SWOT analysis is used in risk management
In a SWOT analysis, risks are identified by identifying threats and weaknesses, while opportunities can contribute to risk mitigation. A thorough analysis of these aspects helps to develop a sound strategy for risk avoidance and mitigation.
The process often includes a brainstorming phase in which all team members consider possible strengths, weaknesses, opportunities, and threats from different perspectives to obtain a complete picture of the risk landscape.
Ishikawa diagram in risk management
The Ishikawa diagram, also known as a fishbone diagram or cause-and-effect diagram, is often used to identify the causes of problems or risks. It helps to systematically analyze complex risk factors in order to understand potential risks and minimize their impact.

Risk factor definition according to DIN 69901-5: 3.97
Influence, event, or circumstance whose occurrence may result in a risk event.
The Ishikawa diagram is based on the idea that many risks do not result from a single factor, but often arise from a variety of causes. These causes are divided into categories and arranged along a central “spine” (which represents the main problem or risk).
Categories in the Ishikawa diagram
The causes of a risk are usually divided into several main categories to facilitate structural analysis. Common categories are:
People | Problems caused by human error or inadequacies, such as insufficient training, poor communication, or unclear responsibilities. |
Machine | Technical problems or lack of infrastructure, such as outdated hardware or software errors. |
Material | Deficiencies in the materials or resources required for the project, such as unreliable suppliers or inadequate product quality. |
Method | Inadequate or ineffective work methods and processes that could jeopardize the project. |
Measurement | Faulty measurement methods or inaccurate data that can lead to incorrect assessments and inaccurate predictions. |
Environment | External factors that influence risks, such as legal changes, political uncertainties, or economic conditions. |
According to the common approaches of IPMA and GPM, risks in projects can be divided into the following risk categories:
Technical risks | These include risks resulting from technical challenges, such as inadequate system integration, outdated technologies, or unexpected technical malfunctions. Such risks can significantly impair the progress and quality of a project. |
Organizational risks | This category includes risks that arise within the project organization. Poor communication, unclear responsibilities, inadequate resource planning, or faulty internal processes can lead to delays or quality problems. |
Management and control risks | Risks directly related to project planning, monitoring, and control fall into this category. These include, for example, unclear goal definitions, a lack of leadership skills, or inadequate stakeholder management. Precise planning and regular reviews help to identify these risks early on and take countermeasures. |
External risks | These risks arise from factors outside the direct project environment. These include market changes, political and legal conditions, economic fluctuations, and natural disasters. Since these influences are often difficult to control, it is important to develop flexible strategies (such as contingency plans or insurance). |
Social risks | Interpersonal aspects can also harbor risks. These include conflicts within the team, unclear communication, or changing expectations on the part of stakeholders. These risks can have just as serious an impact on the success of the project as purely technical or organizational problems. |
Creating the Ishikawa diagram
- The main problem or risk is placed at the “head” of the diagram.
- From there, “bones” are drawn to represent the categories of possible causes.
- Specific causes that can influence the risk are identified under each category. These causes are represented by additional “bones” or branches that attach to the bones.
How the Ishikawa diagram is used in risk management
- The Ishikawa diagram helps to visually represent potential risk factors and recognize that risks are often caused by a variety of factors.
- This method encourages detailed discussion and investigation of each risk and its origins, leading to more accurate assessment and better preparation.
- It is particularly useful in complex projects with multiple potential risks and uncertainties to refine the risk management strategy and develop preventive measures.
Risk analysis and assessment techniques: How to master uncertainty in project management
Risk analysis and assessment is a crucial step in project management for identifying potential hazards at an early stage and developing appropriate measures. With the right methods and techniques, you can minimize uncertainty.

Risk analysis Definition according to DIN 69901-5: 3.95
Project management process that includes identifying and evaluating project risks.

Risk assessment Definition according to DIN 69901-5: 3.96
Quantification of the probability of occurrence and the potential damage for all identified risk cases, as well as discussion of risk factors with non-quantifiable consequences.
Three key approaches to risk analysis and assessment:
Qualitative analysis (e.g., risk matrix): Rapid risk assessment based on probability and impact.
Quantitative methods (e.g., Monte Carlo simulation): Calculation of risks and scenarios based on random variables.
Decision tree and sensitivity analyses: Evaluation of options for action and identification of the biggest risk factors.
Qualitative analysis: A first look at the unknown
Qualitative risk analysis is one of the first steps project managers take to assess risks. This phase is less about precise figures and data and more about assessing risks based on experience and expert knowledge.
What is qualitative risk analysis?
Qualitative analysis involves assessing risk based on criteria such as probability and impact. This is often done using a risk matrix or a risk portfolio diagram, which are simple but extremely helpful tools. The matrix helps to categorize and prioritize risks by assigning them a kind of “danger level.”
- X-axis – probability of occurrence (PO): Probability of the risk occurring (from “very low” to “very high”).
- Y-axis – damage amount (€)/impact: Severity of the risk (from “low” to “catastrophic”).
Each identified risk is then placed in this matrix, allowing for quick visual assessment. To make things even easier, you could use a color scale: green for low risk, yellow for medium risk, and red for high risk. You can then assign the appropriate strategy (accept, mitigate, avoid, transfer) to each of the risk classes formed in this way.
The risk portfolio diagram and the risk matrix are part of qualitative analysis, as they evaluate risks based on assessments (e.g., expert opinions or historical experience). They provide a graphical overview, but no precise numerical values or probability distributions.
Example of a qualitative risk analysis
The project's risk management plan assesses the potential damage of a risk in increments of $1,000. The total project budget of $200,000 is offset by a risk reserve of $10,000. Three levels are defined for assessing the amount of damage:
- Low: damage up to 2,000 euros
- Medium: damage between 2,000 and 10,000 euros
- High: damage over 10,000 euros
The probability of occurrence is also determined in clear 10% increments. The following categories apply:
- Low: up to a maximum of 30%
- Medium: from 30% to 60%
- High: over 60%

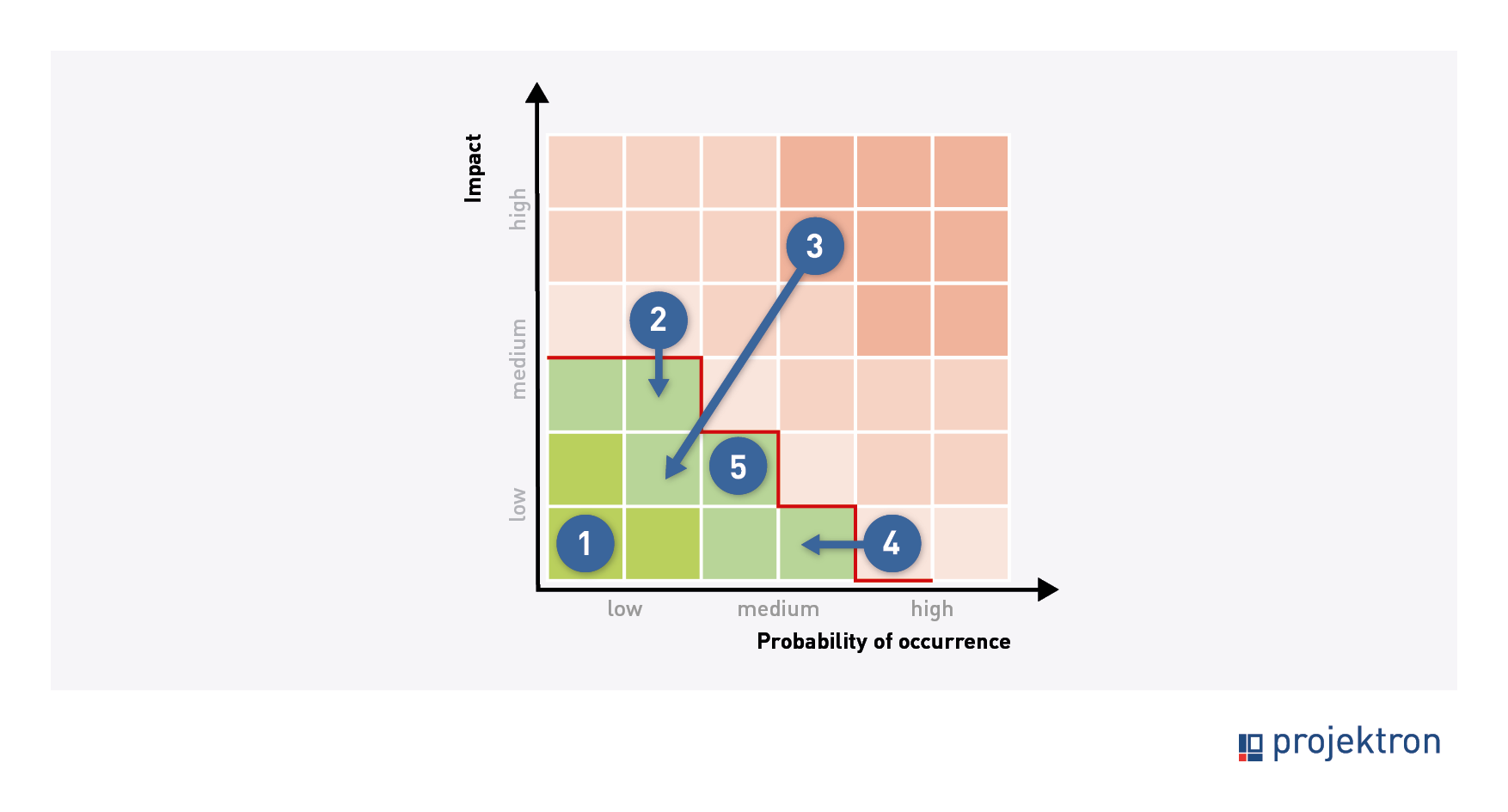

These classifications are combined in a risk matrix. Let's take a possible risk as an example: the failure of important resources. With a probability of occurrence of 40% and an impact that leads to a delay of two weeks, this risk would be classified in the yellow zone of the matrix – i.e., as a medium risk that should be monitored and controlled.
This method enables a quick and clear assessment of risks in the initial phase of risk management without the need for detailed data. However, it should be noted that a purely qualitative analysis is not sufficient to identify all underlying risks.
This technique is particularly useful in the first phase of risk management, as it enables a quick and clear assessment of risks without the need for detailed data. But beware: qualitative analysis alone is often not enough to identify more in-depth risks.
Quantitative methods: when numbers speak
While qualitative analysis provides a good initial assessment, quantitative risk analysis is about making risks truly measurable and calculating their potential impact. Statistical and mathematical models are used to help capture the uncertainties in a project more accurately.
Quantified: calculating risk value
In addition to visual assessment, a simple mathematical calculation helps to express the risk potential in figures:
Risk value (RV) in £ = probability of occurrence (PO) in % × damage amount (DA) or time effect (TE) in £
- PO (%): Probability that the risk will occur
- DA (£): The monetary amount of damage if the risk occurs
- TW (€): Alternatively, the financial damage caused by a delay can also be considered
- RW (€): The total risk in euros
Example: A project could run the risk of important resources becoming unavailable. Based on experience with comparable projects in the company, the probability is 30% and the expected damage is £50,000. The calculation yields:
0.30 × £50,000 = £15,000 risk value
This calculation helps to assess risks more objectively and set priorities.
Create a risk action plan and calculate the provision value
PO1 (%) | PD1 ($) | RV1 ($) | Strategy | Action + Cost | PO2 (%) | PD2 ($) | RV2 ($) | Recommendation | ||
---|---|---|---|---|---|---|---|---|---|---|
Preventive | Corrective | |||||||||
R1 | 30 | 50,000 | 15,000 | A | Redundant resource | Provide replacement staff (5,000) | 10 | 30,000 | 3,000 | Avoid |
R2 | 60 | 20,000 | 12,000 | B | Intensify quality assurance (3,000) | Error resolution budget (4,000) | 40 | 10,000 | 4,000 | Reduce |
- PO: Probability of Occurrence
- PD: Potential Damage
- RV: Risk Value
A risk provision is a financial reserve set aside to cover potential future risks. It serves to cover unforeseen costs that may arise from risks that occur. These should be taken into account accordingly in cost planning.
Determining risk provisions
Risk provisions (RW2) are based on the risk value, but there are several approaches:
- Full provision (conservative): The entire potential loss amount (€50,000) is set aside.
- Risk-based provision (recommended): A percentage of the risk value is set aside (e.g. 70% of €15,000 → £10,500).
- Strategic provision: If there are several risks, a general risk buffer (e.g. 5% of the total budget) can be planned.
Monte Carlo simulation: Looking at risk from different perspectives
Monte Carlo simulation is a method in which uncertainties are modelled in the form of random variables. It is often used to simulate the effects of different risk scenarios on a project, thereby enabling a more accurate forecast.
Monte Carlo simulation runs ‘random numbers’ through the computer and calculates the possible scenarios for each risk. This means that the programme simulates many runs, varying the occurrence of risks randomly each time. At the end, the simulation provides a distribution of possible outcomes that gives information about the probability of certain events occurring.
Decision tree and sensitivity analyses: searching for the best way forward
Decision trees and sensitivity analyses are further valuable tools used in quantitative risk analysis to understand risks and determine the best courses of action.
Decision tree analysis: The guide through uncertainty
Decision tree analysis depicts different decision paths and takes into account the uncertainties along these paths. It is particularly helpful when several alternative courses of action are available and each option involves different risks and opportunities.
A decision tree is a graphical representation in which a decision leads to several possible consequences and their probabilities. The possible outcomes and their effects are shown at each branch of the tree. This allows project managers to identify the option that is least risky and most advantageous.
Example of a decision tree analysis
A project manager must decide whether to introduce new software now or wait for an improved version. The decision tree would show the possible scenarios: If he decides now, there is a high probability of delays and high costs. If he waits, he could get a better product, but it could also take longer.
Sensitivity analysis: How do we respond to changes?
Sensitivity analysis examines how sensitive a project is to certain changes. This method helps to understand which risk factors have the greatest impact on the project outcome.
Individual parameters (e.g. project costs, delivery times or resource availability) are changed and the effects of these changes on the final result are observed. This method helps to identify and manage the greatest uncertainties and potential weaknesses in the project.
Example of a sensitivity analysis
If material costs increase by 10%, how will this affect the overall result of the project? A sensitivity analysis shows exactly which variables have the greatest influence on the project, enabling you to take targeted precautionary measures.
Risk management: exploiting opportunities, controlling risks
Risks are part of everyday life in any project – the question is how to deal with them. Should they be avoided, shared or accepted? There are clear strategies that make sense depending on the situation. ISO 31000 describes four measures for risk mitigation or risk management: avoidance, transfer, reduction and acceptance.
Risk avoidance: Is that even possible?
The safest way to deal with a risk is to prevent it from arising in the first place. However, this is not always possible in practice. So, if risks cannot be completely avoided, the aim is to minimise them.
Some risks can be eliminated by not using certain processes, technologies or procedures in the first place.
Example: A company that is critical of cloud services hosts its data exclusively on its own servers. This eliminates the risk of external data leaks – but it also creates new challenges, such as higher costs and in-house maintenance.
Risk mitigation: From risk to a calculable factor
If a risk is unavoidable, it helps to reduce the probability of its occurrence or the extent of the damage.
Typical risk mitigation measures:
Technical protective measures (e.g. firewalls, backups)
Additional controls and quality assurance
Training for employees to reduce human error
Pilot phases and tests before a large project is rolled out
Example: A software company reduces the risk of program errors by using automated tests and code reviews. This does not eliminate errors completely, but it significantly reduces the probability of serious bugs.
When does a risk reduction strategy make sense?
- When a risk could cause significant damage.
- When mitigation measures are practical and economical.
- When a risk cannot be completely avoided but remains controllable.
Risk transfer: Why bear everything yourself?
Not every risk has to be shouldered by your own company. Some risks can simply be passed on – either to external partners or through hedging.
Insurance: Protection against the unknown
Many companies use insurance to cushion financial risks. The principle is simple: you pay a regular premium and receive compensation in the event of an emergency.
Typical examples:
Cyber insurance that covers damage caused by hacker attacks
Product liability insurance that protects companies from lawsuits
Business interruption insurance in case production is paralysed by external events
Example: An online shop insures itself against data loss due to cyber attacks. If hackers steal sensitive customer data, the insurance covers the costs of restoration and any legal consequences.
Outsourcing: Transferring risks to specialists
Instead of managing risks yourself, it may make sense to outsource certain tasks to external specialists.
Outsource IT security instead of setting up an expensive infrastructure yourself
Outsource logistics to specialised service providers to avoid bottlenecks
Use legal advice to minimise compliance risks
Example: A medium-sized company that wants to expand internationally hires a specialised export company that is familiar with customs regulations and legal hurdles. In doing so, the company transfers the risks of customs violations or delays to an experienced partner.
When does risk transfer make sense?
- When a risk can be financially secured (e.g. through insurance).
- When external specialists can better assess and manage risks.
- When the costs of the transfer are lower than the potential damage.
Risk acceptance: Sometimes you just have to accept it
Not every risk can be avoided, minimised or outsourced. Sometimes the only option is to accept it – but with a plan B up your sleeve.
Conscious risk-taking
Risk management does not mean eliminating every risk at any cost. Sometimes the cost of avoidance exceeds the actual damage.
Example: A start-up could take out expensive insurance against business interruption. But instead of spending a lot of money on low probabilities, the team prefers to plan an alternative financing strategy in case something goes wrong.
When does risk acceptance make sense?
- When the risk is low and the countermeasures would be too expensive.
- When the risk cannot be prevented or transferred.
- When a company is willing to consciously live with the risk.
Contingency planning: Plan B for emergencies
Acceptance does not mean simply ignoring a risk. Instead, a contingency strategy should be in place to minimise damage in the event of an emergency.
Typical contingency measures:
Backup strategies for IT failures
Alternative suppliers for delivery bottlenecks
Crisis communication plans to limit damage to reputation
Example: A company that depends on a few suppliers develops emergency plans for alternative sources of supply. If a factory fails, production remains secure.
The right strategy for every risk
The right strategy depends on many factors:
- How high is the risk?
- How much does it cost to protect against it?
- And what alternatives are there?

Risk response plan definition according to DIN 69901-5: 3.100
Establishment of preventive or corrective measures to avoid, reduce or transfer risks
An overview of the most important approaches:
Strategy | Suitable for… | Advantage |
---|---|---|
Risk Avoidance | Risks with very high potential damage | Completely eliminates the risk |
Risk Reduction | Risks that cannot be avoided but can be reduced | Lowers the probability or the potential damage |
Risk Transfer | Financial or operational risks that external partners can manage better | Distributes risk to third parties |
Risk Acceptance | Minor risks or excessively costly countermeasures | Saves costs when a fallback plan is in place |
Recommended Approach
- Minor risks: No action needed; damages are accounted for.
- Medium risks: Develop preventive measures and contingency plans, regularly review risks.
- High risks: Implement preventive measures, adjust project planning, transfer or cover risks (e.g., through insurance).
Risk management without chaos: clear communication and documentation
Risk management without structured communication is like a doctor's visit without a diagnosis – no one knows exactly where it hurts. Recognizing risks early is only half the battle. To prevent them from turning into sudden crises, you need clear documentation, transparent communication, and regular updates.
But how do you organize this? Is an Excel sheet enough, or do you need advanced tools? Who needs to be informed and when? And how do you ensure that management doesn't pay attention only when the damage is already done?
Smart documentation and effective communication are core elements of risk reporting.
The Risk Register: The Memory of Your Risk Management
A well-maintained risk register or risk log is the central control tool in risk management. It documents identified risks, assessments, actions, and responsibilities – ensuring that nothing falls through the cracks.
What belongs in a risk register?
Risk description: What is it specifically about?
Cause and potential impacts: Why does the risk exist, and what happens if it occurs?
Likelihood of occurrence and severity of impact: How likely is it, and what are the consequences?
Planned countermeasures: What steps minimize or eliminate the risk?
Responsibilities: Who is responsible?
Status: Has the risk already been addressed, is it still open, or has it been resolved?
Practical Example
A software company is planning the launch of a new product. An entry in the risk register might look like this:
Risk | Cause | Impacts | Action | Responsible | Status |
---|---|---|---|---|---|
Server failure on launch day | High traffic overloads the system | Customers can't access the product, damage to reputation | Scale cloud capacity in advance, perform load tests | IT department | In progress |
A risk register should not be a bureaucratic monster, but rather a tool to help keep track of things. Whether you use a spreadsheet or specialized software, it is important that it remains up-to-date and accessible.
Regular Risk Reviews: Risks Are Not a One-Time Thing
Risks change – new ones emerge, others disappear, and some escalate. That's why regular risk reviews are essential.
Updating the risk register: Have the likelihood or impacts changed?
Reviewing countermeasures: Have they been implemented? Are they sufficient?
Identifying new risks: Which developments bring new uncertainties?
Tip: Risk meetings should not be a mandatory exercise with no impact. A clear focus (“What has changed?”) and short, concise discussions will prevent them from becoming a waste of time.
How often should risks be reviewed?
- In projects: At least at every milestone or sprint review
- In the company: Quarterly or semi-annually – depending on the industry and dynamics
- For critical risks: Immediately when circumstances change
Transparent Communication: Everyone Needs to Know What Matters
A risk that only sits in an Excel sheet is of no help to anyone. Good communication ensures that all relevant people are informed and can take action.
Targeted Stakeholder Communication
Not everyone needs every detail – but everyone should know what is relevant to them.
Target Group | What Information Is Important? | How Often? |
---|---|---|
Project Team | Current risks, actions, responsibilities | Weekly or as needed |
Management | Strategic risks, need for action | Monthly or quarterly |
Clients/Suppliers | Risks affecting their collaboration | As needed, early notice |
A supplier might not be able to deliver a crucial component on time due to shortages. The procurement team should communicate early to explore alternative options – before production comes to a halt.
Effective Communication Channels
Regular Meetings: Brief, focused, with clear responsibilities
Risk Reports: For management and decision-makers
Transparent Tools: Collaborative platforms (e.g. Confluence, BCS, SharePoint) help to keep track
Tip: Risks must be clearly communicated. No one wants to read a 30-page report full of technical jargon. Clear statements and visual representations (such as traffic light systems or charts) facilitate decision-making.
Documentation: No paper mess, but traceable decisions
Good documentation not only helps manage risks in a structured way but also allows learning from mistakes.
Traceability: Who made which decision and when?
Learning Effects: Which measures worked – and which did not?
Compliance: In many industries, risk documentation is mandatory (e.g. ISO 31000, ISO 27001).
Tip: Too complex documentation can be off-putting. It’s better to document briefly, concisely, and purposefully rather than creating a data dump with no benefit.
Communication and Documentation Make Risk Management Effective
Good risk management isn’t just about analysis – it’s primarily about clear information and decisions. The best plans are useless if they are not documented, reviewed, and communicated.
Success Factor | Why is it important? |
---|---|
Maintain a Risk Register | Provides clarity and overview |
Regular Reviews | Keeps risks up to date and relevant |
Targeted Communication | Ensures everyone knows the right information |
Efficient Documentation | Provides traceability and learning effects |
Those who view risk management not as a bureaucratic chore but as a living process with clear benefits minimize uncertainty and can even turn risks into opportunities.
Create a risk management plan
A risk management plan describes how risks in a project are identified, assessed, monitored and controlled. It therefore records everything that has been worked out in the previous steps. Like the schedule, cost plan and communication plan, it is an essential component of the project plan.
What does the risk management plan contain?
1. Risk management objectives and strategy
- Definition of the purpose of risk management in the project
- Link to company guidelines and project objectives
- Alignment with regulatory and industry-specific requirements (e.g. ISO 31000, PRINCE2 risk management process)
- Clarification of whether a proactive or reactive approach is being pursued
2. Roles and responsibilities
- Project manager: Overall responsibility for risk management and escalation of risks
- Risk manager: Monitoring of the risk management process and maintenance of the risk register
- Risk owners: Responsible for the analysis, evaluation and implementation of measures for specific risks
- Project team and stakeholders: Identification of risks and support in risk control
- Steering committee (PRINCE2): Strategic evaluation and approval of risk measures
3. Risk process and methods
The process for handling risks comprises the following steps:
a) Risk identification
- Which methods are used?
- Brainstorming with the project team
- Checklists based on experience
- SWOT analysis (strengths, weaknesses, opportunities, threats)
- Lessons learned from previous projects
- Interviews with experts and stakeholders
- FMEA (failure mode and effects analysis)
b) Risk assessment
- Classification according to:
- Probability of occurrence (low, medium, high – often expressed as a percentage)
- Impact on the project (costs, time, quality, resources)
- Prioritisation in a risk matrix
- Quantitative vs. qualitative assessment:
- Qualitative: Subjective assessment of probability and impact
- Quantitative: Monetary assessment of potential financial losses
c) Risk control
Strategies for minimising or exploiting risks:
- Risk avoidance: Eliminate risk (e.g. choose an alternative approach)
- Risk mitigation: Countermeasures to reduce the probability of occurrence or damage (e.g. tests, training)
- Risk transfer: Transfer of risk to third parties (e.g. insurance, outsourcing)
- Risk acceptance: Acceptance of a residual risk if the costs of the measures exceed the benefits
d) Risk monitoring
- Regular reviews and updates of the risk register
- Indicators for early detection
- Escalation mechanisms for critical risks
4. Documentation and tools
- Risk register: Overview of identified risks, assessment, measures and responsible persons
- Reports and dashboards: Visualisation of the risk status
- Software tools such as Projektron BCS for structured risk management
5. Communication plan
- Internal communication
- Who informs whom about risks?
- Regular meetings and reports for the project team and management
- External communication
- Information for customers, partners or authorities
- PRINCE2-typical risk communication to the steering committee
- Escalation mechanisms
- When and how are critical risks escalated?
- What approvals are required?
6. Budget for risk management
- Risk provisions: Financial buffers for unforeseen risks
- Costs for countermeasures: Resources for training, security measures, insurance
- Expenses for risk management activities: Analysis, meetings, reporting
Specific methods in risk management: strategies for secure projects
Fortunately, there are proven methods that help to structure uncertainties, evaluate them systematically and make well-founded decisions. Four well-known approaches are M_o_R® (Management of Risk), PRINCE2 risk management, FMEA and bow-tie analysis. We show you when each method is best suited.
M_o_R®: Das strategische Framework für Risikomanagement
M_o_R® stands for Management of Risk and is a structured framework for identifying, analysing and controlling risks. It originated in the United Kingdom and is often used in the public sector, but also in companies worldwide. The method takes a holistic approach and can be applied at both a strategic and operational level.
The four core elements of M_o_R®
M_o_R® is based on four central elements that cover the entire risk management process:
- Basic principles: Best practices that ensure that risk management is embedded in the corporate strategy.
- Approach: Definition of roles, processes and reporting lines.
- Processes: From identification to control and improvement of the risk strategy.
- Embedding and review: Ensuring that risk management is actually practised and further developed.
When is M_o_R® suitable?
When an organisation wants to establish a structured, holistic risk management system.
When risks need to be considered not only at the project level, but also strategically.
PRINCE2 and risk management: managing risks in a project context
PRINCE2 (Projects IN Controlled Environments) is one of the most widely used project management methods worldwide and focuses on the systematic integration of risk management. Within the PRINCE2 framework, there are specific roles, processes and strategies for dealing with risks.
The most important elements of PRINCE2 risk management
Risk register: All risks are recorded in a structured document and updated regularly.
Risk strategy: Predefined guidelines on how the team should deal with risks.
Assessment according to probability and impact: Similar to the risk matrix, a classification is made.
Catalogue of measures: Measures for risk avoidance, minimisation or transfer are defined.
When is PRINCE2 risk management suitable?
When projects are already running according to PRINCE2 and risk management needs to be integrated directly.
When a clearly defined, standardised process for risk management is required.
PRINCE2 method in project management: basics, strengths, and weaknesses
As standardized approaches, project management methods provide guidance for planning, executing, and controlling projects. PRINCE2 is a process-oriented method that can be scaled and places the benefits of a project at the center of project management. Our technical article provides an introduction to the basic idea, strengths, and weaknesses of the PRINCE2 method.
Further methods: FMEA and bow-tie analysis in comparison
In addition to M_o_R® and PRINCE2, there are many other methods for risk analysis. Two particularly interesting approaches are FMEA (Failure Mode and Effects Analysis) and Bow-Tie Analysis.
FMEA: Systematic error prediction
Failure Mode and Effects Analysis (FMEA) originated in the aerospace industry and is now used in many industries. It is used to identify potential sources of error at an early stage and assess their impact.
- Identification of potential errors in a process or product.
- Assessment based on three factors:
- Probability of occurrence
- Significance of the impact
- Detectability
- Calculate the risk priority number (RPZ): The three factors are multiplied together.
- Develop measures to reduce risks with a high RPZ.
Example: An automobile manufacturer uses FMEA to identify weaknesses in production. A problem with the brake system is detected and rectified before the vehicle goes on sale.
FMEA is particularly suitable for technical and industrial processes where errors can have serious consequences.
Bow-tie analysis: Visualizing risks
Bow-tie analysis represents risks graphically in a loop shape (hence “bow tie”). It links the causes of a risk with its possible consequences.
- Place the central hazard (e.g., data loss) in the middle.
- List the causes of the risk on the left.
- Show the possible consequences on the right.
- Insert protective measures between the cause and the hazard and emergency measures between the hazard and the consequences.
Example: A company uses the bow-tie method to analyze the risk of a cyberattack. On the left are possible causes such as phishing or unsecured networks, and on the right are the consequences such as data loss or damage to reputation. Preventive measures (firewalls, training) and emergency strategies (backups, incident response) are entered in between.
Bow-tie is particularly suitable for risks with far-reaching consequences, such as IT security, compliance, or occupational safety.
Which method is right for your project?
The choice of the right method depends heavily on the project context. Here is a brief overview:
Method | Suitable for... | Advantage |
---|---|---|
M_o_R® | Organizations with strategic risk management | Holistic approach |
PRINCE2-Risikomanagement | Projects with standardized processes | Clear integration into PM methods |
FMEA | Technical & industrial processes | Identification of error sources in advance |
Bow-Tie-Analyse | Risks with complex causes and effects | Clear visualization of protective measures |
If you are managing a single project, PRINCE2 or Bow-tie could be the right choice. If the entire company wants to establish risk management, M_o_R® is recommended. In production or engineering, FMEA is often the best solution.
Risk management needs minds: roles, responsibilities, and cooperation
Risks cannot simply be written down in a table and ticked off – they must be actively managed. This requires clear responsibilities, committed stakeholders, and a corporate culture that sees risks not as threats but as factors that can be shaped. But what are the most important roles in risk management? Who bears what responsibility? What does the project manager do, and what does the risk manager do? And why should management not just stand by and watch, but actively support?
The project manager: captain with an eye for risk
Project managers already have a lot of responsibility – budgets, schedules, resources. But without good risk management, even the best project concept can quickly fail.
What role does the project manager play in risk management?
A project manager must identify, assess, and control risks at an early stage. This means
Integrating risk analysis into project planning
Controlling and prioritizing preventive measures
Sensitizing the team and stakeholders to risks
Making quick decisions when unexpected problems arise
Example: A software project is at risk of falling behind schedule due to limited developer capacity. A forward-thinking project manager plans additional resources or alternative working models at an early stage instead of waiting until delays are imminent.
Project manager vs. risk manager – who does what?
While the project manager keeps an eye on the risks, a dedicated risk manager (if available) is responsible for in-depth analysis and methodology. Together, they form a strong team.
The risk manager: detective and strategist
Not every company or project has its own risk manager – but when they do, they play a central role.
Tasks of the risk manager
Systematic risk identification and assessment
Developing strategies for risk minimization
Monitoring and documenting risk management
Advising the project manager and management
Example: A manufacturer is introducing a new product. The risk manager identifies potential production bottlenecks and recommends alternative suppliers. Thanks to this preparation, production remains stable even if a supplier fails to deliver.
When do you need a dedicated risk manager?
For complex, high-risk projects
When legal requirements call for systematic risk management
In companies that have made risk management an integral part of their strategy
If a company does not have its own risk manager, the project manager takes on this task with the support of the team.
Stakeholders: Involve them early on instead of surprising them later
Risk management only works if all relevant players are involved from the start. These include:
Specialist departments: They have the expertise on potential risks in their area.
Customers: Risks on the customer side (e.g., market changes) often influence the project.
Suppliers: Bottlenecks or delays affect the risk profile.
Regulatory authorities: In regulated industries in particular, risk management must be aligned with regulations.
Why is interdisciplinary collaboration worthwhile?
Risks are identified earlier and assessed more comprehensively
Solutions emerge from different perspectives
Decisions are based on well-founded information
Example: An IT project team is planning a new feature. The compliance department is not involved – until shortly before launch, when it becomes clear that data protection requirements are not being met. The result? Delays and high rework costs.
Solution: Regular communication with compliance experts would have identified and avoided the risk at an early stage.
Management commitment: Nothing works without support
Risk management only works if management stands behind it. A CEO who says “go ahead” but does not provide resources undermines the entire process.
What does management commitment mean in concrete terms?
Allocate budget and resources for risk management
Integrate risk analysis into the corporate strategy
Promote risk awareness as part of the corporate culture
Risk culture: Avoid mistakes or deal with them openly?
Many companies deal with risks according to the motto “just don't make any mistakes.” But mistakes cannot always be avoided – and risks that are identified too late are more dangerous than those that are addressed early on.
A healthy risk culture means:
Seeing mistakes as learning opportunities
Communicate risks openly
Address problems early on instead of hiding them
Overview: Clear roles, strong teams, secure risk management
Without defined responsibilities, risk management remains theoretical but ineffective. The most important players at a glance:
Role | Tasks | Important because... |
---|---|---|
Project manager | Identify risks early on, control measures | Projects remain efficient and do not fail due to unexpected problems |
Risk manager | Systematic analysis and monitoring | Risks are viewed strategically and documented |
Stakeholders | Assess risks from different perspectives | Expertise is incorporated and there are no nasty surprises |
Management | Promote a risk culture, provide resources | Risk management is implemented effectively |
Successful risk management is not a one-person job. It requires cooperation, clear responsibilities, and a corporate culture that sees risks as a factor that can be shaped.
Typical mistakes in risk management and how to avoid them
Risk management sounds reassuring at first – after all, it involves taking precautions, analyzing, and planning. But reality shows that many projects fail not because of the risks themselves, but because of wrong decisions in dealing with them. What are the most common pitfalls, and how can they be elegantly avoided? A look at typical mistakes and proven solutions.
Mistake 1: Overlooking or misjudging risks: the blind spot problem
A risk register that reads like a shopping list for the end of the world is of no use to anyone – nor is an overly optimistic view that excludes significant dangers. Incomplete risk identification and a lack of prioritization are among the most common mistakes in risk management.
Typical causes
- Tunnel vision: Teams focus only on known or obvious risks.
- One-sided perspective: Stakeholders from different areas are not involved.
- Lack of prioritization: All risks end up on a list, but without clear classification according to probability of occurrence and impact.
Solution
- More eyes see more: Involve experts from different departments and stakeholders.
- Use structured methods:SWOT analysis, failure mode and effects analysis (FMEA), or Monte Carlo simulation help to assess risks in a well-founded manner.
- Prioritization according to a clear system: The risk matrix according to ISO 31000 is a proven tool for classifying risks according to their significance.
Mistake 2: Communication and documentation: When risk management gathers dust in a drawer
A great risk management concept is of little use if no one knows about it or uses it. Communication deficits and faulty documentation are classic weaknesses – and a breeding ground for crises.
Typical causes
- Lack of exchange: Information remains in silos and does not reach all relevant parties.
- Complexity trumps clarity: Endless tables and reports that are difficult to understand ensure that no one really lives and breathes risk management.
- Documentation as a chore: Protocols exist but are not updated or used.
Solution
- Regular risk updates: Meetings in which risks are actively discussed and adjusted.
- Visual and clear presentation: A clear dashboard or traffic light logic makes risks more tangible than a 50-page report.
- Promote transparency: Relevant information must be easily accessible to all project participants.
Mistake 3: Static risk assessment: When plans don't keep pace with reality
Risks are not set in stone. They evolve, change their nature, or disappear. Those who do not regularly adapt their risk management run the risk of responding to yesterday's problems with yesterday's solutions. A lack of updating and responsiveness in a crisis is therefore a serious problem.
Typical causes
- “We checked that months ago!”: Risks are identified once and then ignored.
- No early warning systems: Problems often announce themselves – if you pay attention to the right signals.
- Sluggish response: Emergency plans exist, but no one knows or practices them.
Solution
- Establish dynamic risk management: Regularly reassess and adjust risks.
- Define early warning indicators: What signals indicate an escalation?
- Test crisis response plans: Only those who practice in calm times can act confidently in an emergency.
Risks in motion: Risk management in agile projects
Agility and risk management are not mutually exclusive – quite the contrary. Those who identify risks early on, respond flexibly, and integrate them as an integral part of the development process ensure more stable and successful projects. The goal is not to eliminate all risks, but to deal with them quickly and effectively – in line with agile principles.
Agility means flexibility, rapid adaptation, and continuous improvement – but it also means uncertainty. In traditional projects, risks can often be identified early on, analyzed, and minimized with long-term measures. Agile projects, on the other hand, thrive on short cycles, dynamic requirements, and a high degree of change. How can risk management be integrated into this environment without slowing down agility?
Risks in agile methods: A dynamic playing field
Agile methods such as Scrum, Kanban, and SAFe are designed to respond quickly to change. They promote transparency, personal responsibility, and continuous improvement. But it is precisely this flexibility that brings new challenges for risk management.
Traditional projects often start with a detailed risk analysis that lists and evaluates all potential hazards and proposes countermeasures. However, this rigid approach does not work in an agile environment because:
Plans are constantly changing: Risks that are relevant today may be obsolete tomorrow.
Traditional risk models are too slow: Those who first create a detailed risk document before taking action lose speed.
Team structures work differently: Responsibility no longer lies with a single risk management department, but is distributed across the entire team.
Typical challenges in agile risk management
Agile projects place special demands on risk management. Here are some of the most common stumbling blocks:
Short iterations: Risks can change in every sprint or Kanban phase, which requires continuous monitoring.
Dynamic requirements: Often, not all details are known at the start of a project, which makes risk analysis difficult.
Self-organized teams: Responsibility for risk management is often not clearly defined.
Lack of long-term planning: While traditional projects often plan years in advance, agile teams tend to think in terms of weeks or months.
Practical solutions
Agile teams should view risks not as obstacles, but as natural companions to every project. The following strategies help to identify and manage risks at an early stage:
Integrate risk management into the sprint plan: Every sprint planning session should include a discussion of potential risks. This allows critical issues to be incorporated directly into the development cycle.
Make risks visible on the Kanban board: A separate “risks” swimlane or special cards help to keep hazards transparent.
Include agile roles: The Scrum Master or Agile Coach can take on a moderating role and ensure that risks are discussed regularly.
Introduce regular risk stand-ups: A weekly exchange about new or changed risks helps to keep the team up to date.
Iterative risk management: Adaptation as a success factor
In classic projects, a comprehensive risk analysis is one of the first steps. The aim is to anticipate all possible problems and plan long-term measures. Agile projects, on the other hand, rely on continuous learning and adaptation, which requires a more dynamic approach to risk management.
Why risk management must be iterative
Static risk analyses have no place in an agile environment. Instead, teams must reassess risks in each iteration and adapt their strategies. The following factors play a role here:
New risks emerge: Changes in requirements, technical challenges, or unexpected market developments can give rise to risks that were not foreseeable at the outset.
Assessments must remain flexible: A risk that was classified as critical in Sprint 1 may be irrelevant in Sprint 5 – or vice versa.
Teams learn from mistakes: Agile projects are based on the idea of continuous learning. Mistakes are not seen as problems, but as opportunities for improvement.
Effective methods for iterative risk management
Use regular retrospectives for risks: Every retrospective offers an opportunity to talk not only about processes, but also about risks. Which dangers have materialized? Which risks were underestimated?
Integrate risks into user stories: Agile teams can incorporate risks directly into their user stories: “As a development team, we want to minimize the risk of faulty API integration by creating a prototype at an early stage.”
Involve stakeholders and customers early on: Risk management works best when everyone involved provides regular feedback. Customers and stakeholders can often point out risks early on that the team itself is not aware of.
Embrace a “fail fast, learn faster” mentality: Instead of avoiding risks, agile teams should test risks early on and learn from failures. An experimental approach helps to find solutions more quickly.
Tradition meets agility: adapt proven methods intelligently
Even though agile risk management needs to be flexible and dynamic, that doesn't mean traditional methods are obsolete. Many classic approaches can be adapted to meet the requirements of agile teams:
Lightweight risk registers instead of extensive documents: Instead of maintaining a detailed risk register, teams can use a simple “risk wall.” Risks are noted on cards, prioritized, and regularly updated.
Simple assessments instead of complex risk models: Instead of detailed probability calculations, a rough assessment (high, medium, low) is often sufficient.
Keep crisis response plans dynamic: A static emergency plan is of little use when conditions are constantly changing. Instead, agile teams should develop flexible workarounds that can be quickly adapted as needed.
Record lessons learned for future projects: Even though agile projects are fast-paced, it is worth leveraging documented insights from previous projects. A well-managed knowledge database can help avoid typical risks in new projects.
Scrum in software development: agile and structured
When it comes to agile software development methods, there's one term you can't avoid: Scrum. But what exactly is Scrum, and how does it demonstrate its strengths in software development? What roles and activities are involved in Scrum? What are the advantages and disadvantages of this agile framework? You will find out all this in this article. In addition, we will give you an insight into our agile Scrum variant, which we use successfully to develop Projektron BCS. We use BCS as our Scrum software.
Software tools for efficient risk management
Software helps project organizations to record risks in a structured manner, clearly define responsibilities, and implement countermeasures efficiently. But what features should good risk management software have, and which tools are best suited?
Requirements for powerful risk management software
Risk management is a decisive factor for project success. Choosing the right software depends on the requirements of the company. However, effective risk management always requires more than just an Excel spreadsheet with risk categories. Specialized software should offer the following:
Risk register and assessment: All risks must be recorded centrally and assessed according to probability and impact.
Automated notifications and workflows: Risks change over the course of a project. The software should provide timely reminders of escalations and actions.
Flexibly customizable risk matrices: Companies and projects have different risk assessments. A good tool allows for flexible configuration.
Integration with other project management functions: Risk management is not an isolated process. The software should integrate seamlessly into the existing PM infrastructure.
Transparency and documentation: Who assessed which risk? What measures were taken? Audit-proof documentation is essential.
Projektron BCS: The Ideal Solution for Integrated Risk Management
While specialized tools offer in-depth analyses, they often lack integration with overall project management. Projektron BCS combines the best of both worlds: fully integrated risk management within a powerful project management software that supports traditional, agile, and hybrid approaches equally well.
With Projektron BCS, you can identify and categorize potential risks during the preparation and planning phases. BCS distinguishes between project risks and corporate risks. While project risks include challenges such as delays or resource shortages, corporate risks are used for the ongoing monitoring and management of operational risks.
The following parameters can be stored for systematic risk assessment:
Risk categories: Political, scheduling, economic, technical, or safety-related risks.
Probability: Probability of occurrence in percent.
Severity: Assessment of the possible effects.
Overall risk value: Automatic calculation based on probability of occurrence and severity.
A central overview allows risks to be documented in detail, responsible parties to be assigned, and dependencies to be analyzed. This facilitates forward-looking planning and prioritization of countermeasures.
According to PRINCE2, risks are an essential part of the business case, as they provide information about factors that could jeopardize the profitability of the project. Initial risks can arise as early as the SU (Starting up a Project) planning phase, which is why early detection and the initiation of appropriate measures are crucial for the success of the project. In Projektron BCS, a specialized PRINCE2 assistant guides you through the identification, recording, evaluation, and analysis of risks and the definition of countermeasures.

Nicole Baumann, Project Management Excellence, Kendrion Automotive Group
“We are currently working on making greater use of opportunity and risk management in order to have project-related data available in an even more consolidated form in one place. The risk charts are already an integral part of our gate presentations.”
Efficient Risk Mitigation through Targeted Countermeasures
Projektron BCS allows the systematic development and management of countermeasures. Preventive measures reduce the likelihood of a risk occurring, while corrective measures aim to mitigate risks that have already materialized.
By linking countermeasures to tasks, costs, and schedules, the impact of the measures on the overall risk can be transparently tracked. The software also provides status management to monitor the progress of the measures – from the proposal phase through approval to execution.
Especially valuable: Projektron BCS automatically calculates the resulting risk reduction and visually displays potentially negative effects of countermeasures. This allows you to quickly determine whether a measure is economically viable or if adjustments are necessary.
Graphical Evaluation and Reporting
To provide a clear representation of the risk situation, Projektron BCS offers various charts. Risks can be graphically visualized by severity and probability of occurrence. These representations facilitate communication with stakeholders and enable data-driven decision-making.
Additionally, risks and countermeasures can be documented in reports. This gives project participants, managers, and clients a transparent overview of the risk strategy and planned actions.
Why Projektron BCS for Your Risk Management?
With its integrated functions for risk identification, assessment, and control, Projektron BCS helps companies implement projects safely and predictably. The benefits at a glance:
Early risk detection through systematic capture and categorization.
Detailed assessment through probabilities of occurrence, severity levels, and automation of calculations.
Targeted risk mitigation through preventive and corrective countermeasures with cost-benefit analysis.
Clear reporting through visual representations and customizable reports.
Transparency and traceability for all project stakeholders.
Whether in IT, software development, healthcare, or mechanical engineering – professional risk management is crucial for project success.
If you want to not only manage risks but truly control them, try Projektron BCS now for free and with no obligation!

Andrea Fischer, Back Office Project Assistant at team Technology Management GmbH
“Our primary requirement for the software was that it be able to map as many of our business processes as possible, including project management, opportunity and risk analysis, quotation and approval processes, internal controlling, performance recording, billing processes, and stakeholder analysis.”
Use case: Risk management and process optimization in finance and controlling at SSC-Services GmbH
SSC-Services GmbH, an IT service provider with a focus on the automotive industry, has been relying on Projektron BCS for over ten years to optimize its internal processes in the finance and controlling sector. A key benefit lies in the integrated risk management, which enables SSC to systematically document project-specific risks and opportunities and demonstrably meet the requirements of TISAX and ISO certifications.
The company has achieved significant efficiency gains particularly in the area of automated invoicing. Proofs of effort, acceptance reports, and invoice attachments are generated directly from BCS and sent via email. The integration with CRM, project, and contract data ensures complete traceability – a crucial advantage for audit-proof processes and controlling.
SSC-Services demonstrates how risk management can be seamlessly integrated into operational processes while significantly reducing administrative effort through intelligent automation in controlling and billing processes.

Tanja Maier, Controlling, SSC-Services GmbH
“Most recently, the requirements from the certifications and labels relevant to us in the area of project risk management were implemented. Among other things, this helps us to meet the requirements of the TISAX and ISO labels. We store agreements such as service level agreements and confidentiality agreements for the relevant projects, record whether relevant information is processed in the project, and ensure that a schedule has been agreed contractually. Risks and, where applicable, opportunities are recorded in the project by the project manager.”
Conclusion: The added value of systematic risk management
Risks cannot be avoided – but they can be managed. Anyone who wants to be successful in projects must consciously address risks, identify them, evaluate them, and manage them in a targeted manner. Systematic risk management is not a tedious chore, but a decisive factor for success.
Effective risk management is characterized by the following key aspects:
Early risk detection: Risks that are detected too late can be costly. Systematic identification ensures that countermeasures can be taken at an early stage.
Dynamic adaptation: Risks are not static problems. They evolve – and risk management must evolve with them.
Integration into everyday project work: Risk management must not be an isolated process. It should be seamlessly integrated into existing workflows.
Combination of technology and methodology: Modern software solutions such as Projektron BCS support risk management with structured workflows, clear responsibilities, and monitoring functions.
A look into the future: Where is risk management headed?
Risk management methods and tools are constantly changing – and you can benefit from these developments. Artificial intelligence, big data, and automated tools are revolutionizing the way you identify and assess risks.
Here are some trends that will become more important in the future:
Automation and AI-supported analysis: Algorithms can identify risk patterns earlier and recommend actions.
Real-time risk tracking: Digital dashboards and live analytics enable continuous risk monitoring.
Better integration with agile methods: Risk management is becoming more flexible and better aligned with rapid development cycles.
Increasing regulatory requirements: Companies must prepare for stricter compliance requirements.

About the author
Kai Sulkowski is an editor in the marketing department at Projektron and an expert on project management topics. With many years of experience in analyzing and preparing complex technical content, he provides in-depth knowledge of best practices, methods, and trends in project management. His focus is on providing practical content that helps companies manage their projects efficiently.
Further interesting articles on the Projektron blog

Project communication
One of the main reasons for project failure is a lack of project communication - according to a PMI study, communication management in a project is just as important as an accurate cost estimate, a clear definition of project goals and a thorough risk analysis. 3 practical tips for your project communication!

Project flowchart
A project flow chart is an important part of the project plan and the basis for many other plans. Here you can find out everything you need to know about the project flow chart, get a template and examples of the project flow chart as a list, network plan and Gantt chart.

Resource planning
Resource planning is a strategically important step in project management. What is a resource plan? What information does it contain? What are the benefits of resource planning in project management? Here's resource planning from A to Z.

Project structure planning
It is considered the plan of plans or the mother of all plans in classic project management: the work breakdown structure (WBS). Find out how you should proceed when creating a work breakdown structure here.
